The Developer, TfL and intermediary Head Leaseholder (Lunaprop) entered into the Conditional Agreement on 30th November 2022. Upon exchange a £1M capital payment was paid by the Developer to TfL. The remaining £9M will be paid upon Completion (and satisfaction of the conditions detailed below) at Gateway 1.
Subject to satisfaction of certain conditions in the Conditional Agreement, the parties (or the relevant parties) will enter into the following:
1. a headlease of the Office Site to be granted by LUL to the Developer (“Headlease 2”) and a headlease of the Office Site to be granted by LUL to Lunaprop (“Headlease 1") which will sit above Headlease 2 (the “Headleases”);
2. a works agreement relating to the development of the Office Site (the “Works Agreement”);
3. two landscaping licences relating to land adjoining the Office Site (the “Landscaping Licences”);
4. a construction agreement relating to Lunaprop’s interest in the development of the OfficeSite (the “Construction Agreement”) – the operative provisions of the Construction Agreementare tied to the satisfaction of the Conditions in the Conditional Agreement although it is enteredinto at the same time as the Conditional Agreement;
5. an overage deed relating to the sharing of profit from the development of the Office Site (the “Overage Deed”) and
6. a crane oversail licence relating to land adjoining the Office Site (the “Crane Oversail Licence”).
All these documents are in an agreed form and annexed to the Conditional Agreement.

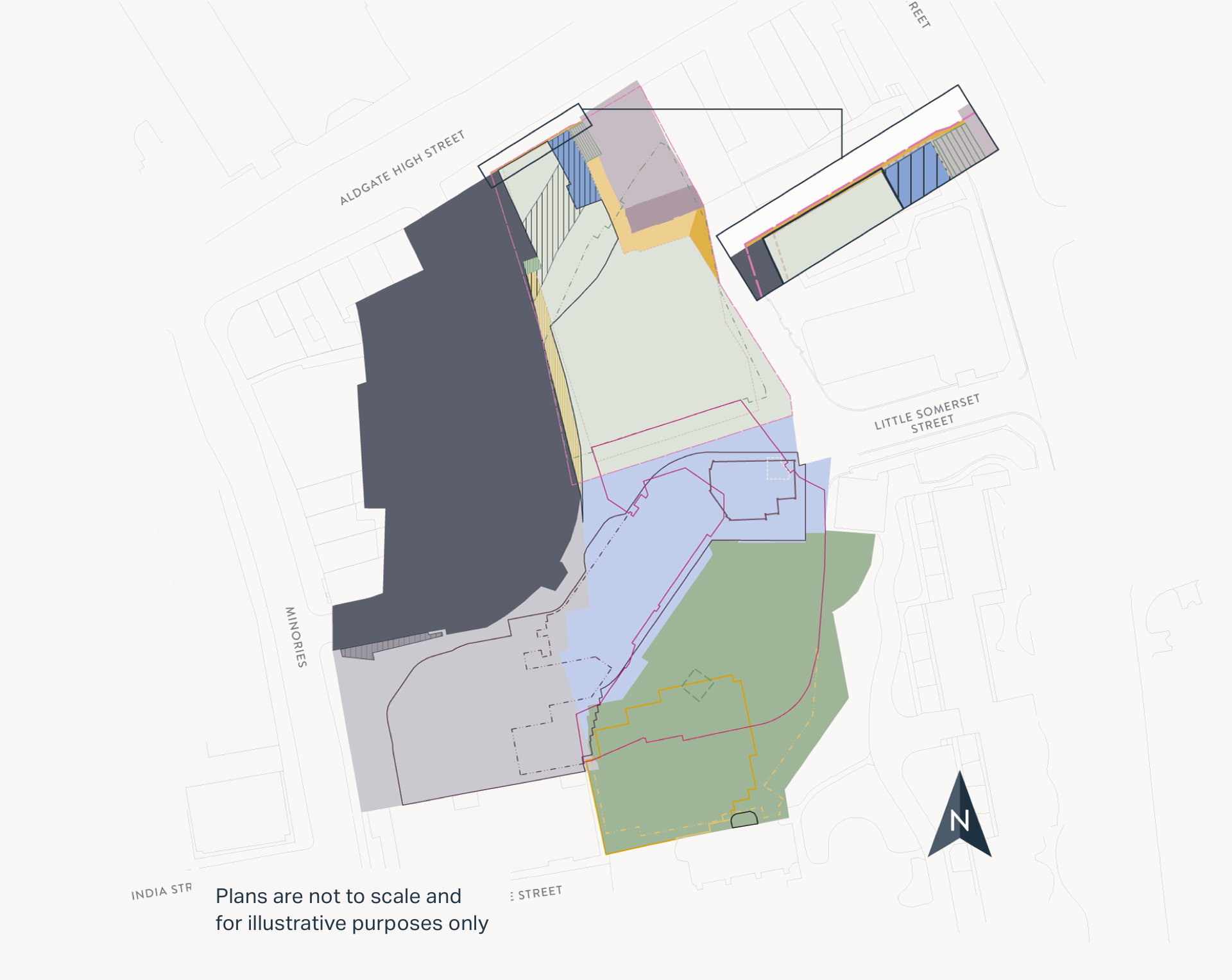

The current ownership of the site is held under various Freehold and Long Leasehold titles by either TTLP (TfL) or 4C Minories 2 Limited (4C Group).

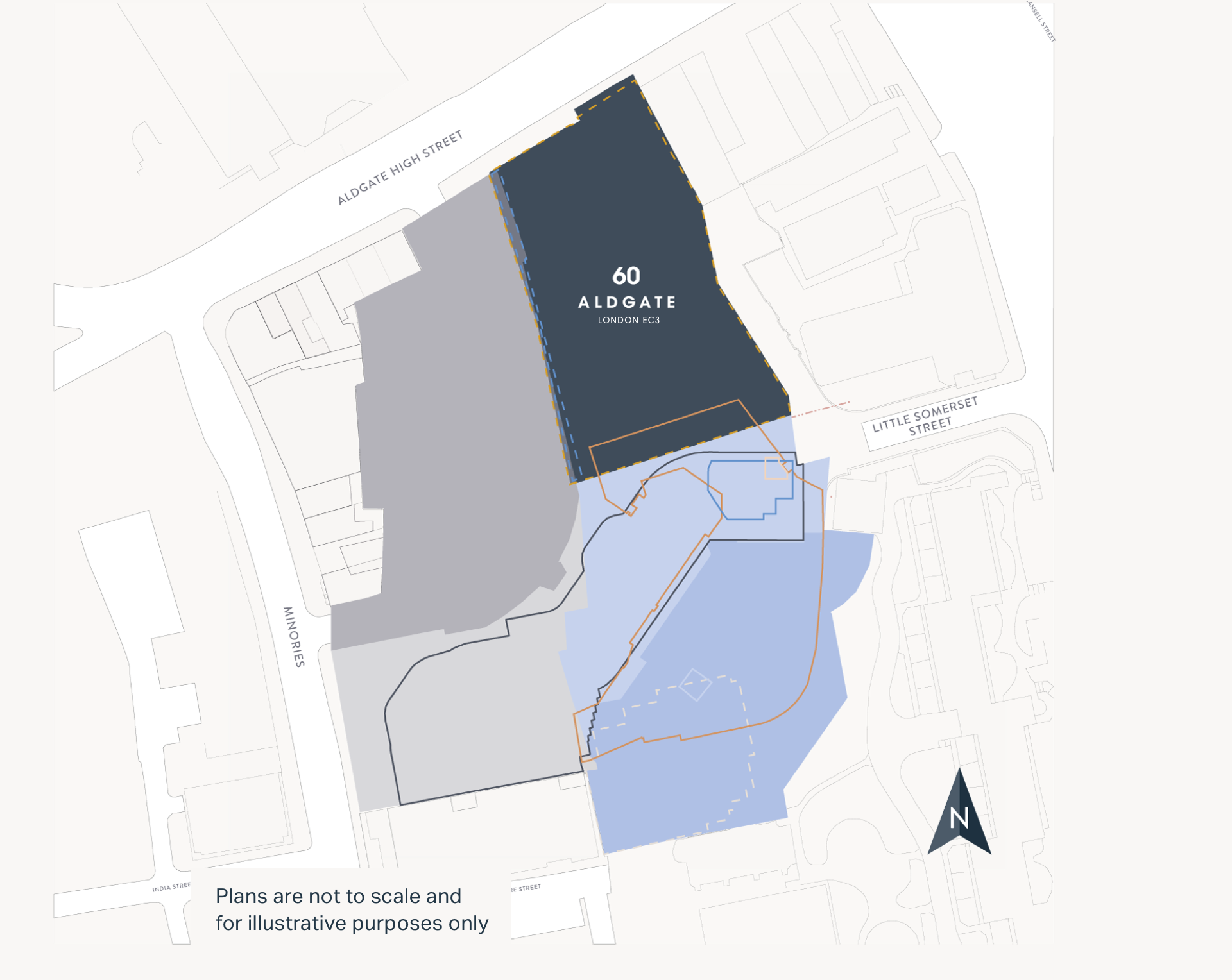

On completion of the transaction, the Freehold Property will be merged into one title under TfL’s ownership. The Leasehold property will be surrendered, including the LCR lease. The following steps will then occur:
Following completion at Gateway 1, the ownership structure will be as follows:
Freehold interest, subject to receipt of a 2.5% gearing of rents receivable and a minimum ground rent of £170,000 per annum following Practical Completion.
500 year Long Leasehold interest, subject to a gearing of 2.5% of rents receivable and a minimum ground rent of £170,000 per annum following Practical Completion.
500 year lease, subject to a gearing of 5.0% of rents receivable and a minimum ground rent of £375,000 per annum following Practical Completion.
The Conditional Agreement has been entered into between TTL Properties Limited (“TTLP”), London Underground Limited (“LUL”), the Developer; and Lunaprop.
This agreement is subject to a time period of 2 years from the 30th November 2022 (the Longstop Date), in which time the Developer must use all reasonable endeavours to satisfy the Conditions (except the s.163 Condition) in order for Gateway 1 ‘Completion’ to occur. All other documents to be entered into at Gateway 1 are appended to the Conditional Agreement in an agreed form. The Conditions are:
Completion of the Conditional Agreement
Completion of the Conditional Agreement will occur 20 business days from the date on which the Development Notice is served.
The Development Notice is the notice to be given by the Developer to LUL specifying that:
Waiver of Conditions
TTLP, LUL, the Developer and Lunaprop may agree to waive any of the Conditions (save for the S.163 Condition which may only be waived by LUL) by agreeing to do so in writing. Upon such waiver by all parties, the relevant Condition shall be deemed satisfied.
Works Agreement
At Gateway 1, the Works Agreement will be entered into which governs the requisite approval processes and clear pathways to consent required from TfL.
The document also details the infrastructure protection provisions, insurance and warranty provisions and design framework. The intention of this document is to streamline the approvals process required to mitigate undue delays.
Headleases
The Agreement for Lease(s) are annexed to the Conditional Agreement. At Gateway 1 the site will be held by way of a new 500 year Long Leasehold from London Underground Limited (TfL), geared to 5.00% of Rents Receivable subject to a minimum ground rent of £375,000 per annum from Practical Completion.
Headlease 2, the Developer lease is a 500 year interest geared to 5.00% of Rents Receivable. There is an intermediary headlease held by Lunaprop Aldgate Limited which is a passive interest retaining 2.5% of the ground rent paid by Headlease 1 (subject to a minimum of £205,000 p.a).
The other documents that have been agreed and are annexed to the Conditional Agreement include, two landscaping licences relating to land adjoining the Office Site, a construction agreement relating to Lunaprop’s interest in the development of the Office Site – the operative provisions of the Construction Agreement are tied to the satisfaction of the Conditions in the Conditional Agreement, an overage deed relating to the sharing of profit from the development of the Office Site and a crane oversail licence relating to land adjoining the Office Site.
It has also been agreed with TfL that enabling works to include the diversion of a COLT cable and sewer located on the Office Site can be undertaken outside the legal and indemnity requirements of the above agreements. However, an asset protection agreement may be required.
between TTL Properties Ltd, London Underground Ltd, the Developer and Lunaprop.
This agreement is subject to a time period of 2 years from the 30th November 2022 (the Longstop Date), in which time the Developer must use all reasonable endeavours to satisfy the Conditions (except the s.163 Condition) in order for Gateway 1 ‘Completion’ to occur. All other documents to be entered into at Gateway 1 are appended to the Conditional Agreement in an agreed form.
Upon exchange a £1M capital payment has been paid by the Developer to TTLP.
to satisfy the conditions contained in the CA.
The grant of planning permission including signing of the s106 and expiry of the Judicial Review period.
The grant of planning permission (agreement of s106 + expiry of the JR period), satisfaction of the site separation condition and completion of any required planning agreement e.g., s278. All of which are to be freefrom any Onerous Conditions
Procuring the termination of all the leases, tenancy agreements, licences to occupy and other documents granting a right to possession or occupation
...or use of the 4C Freehold Property, the 4C Leasehold Property or the Third Party Land to the extent necessary to effect the sale to LUL of the 4C Freehold Property, the Third Party Land and the 4C Leasehold Property in each case with vacant possession on actual completion.
Procuring the satisfactory purchase of the third party land from the Crown Estate and the City of London Corporation ‘ Charter Streets’
..., and entry into one or more satisfactory BMU Contracts for the acquisition of the rights required by the parties over the Third Party BMU land.
TTLP and the Developer procuring ‘Satisfactory Surrender 1’ and entering into the ‘Option Agreement’.
“Satisfactory Surrender 1” – a surrender of the part of the LCR airspace lease required to enable the development to be implemented including to the extent LCR has a relevant interest, it contains a consent to the grant of the Landscaping Area Licences, which is binding on LCR.
The airspace required under Surrender 1 will be acquired prior to a Funder coming onboard.
The Option Agreement relates to a slither of land which may be necessary to satisfy the 2.5M set back provision required by Building Control to comply with fire regulations. A rate psf for this land has been agreed and is documented. The Developer can elect to exercise this Option prior to Gateway 1 if the land is required.
The appointment by the Developer of the Demolition Contractor and the Development Manager
...(meaning such suitably qualified and experienced demolition contractor as approved by LUL in accordance with the Works Agreement and the “Development Manager” (meaning Rocket Properties Development Management Limited or such other suitably qualified and experienced development manager as approved by LUL in accordance the Works Agreement. Appointments and warranties in favour of LUL will need to be provided.
The Development Plans will be progressed by the Developer to RIBA Stage 3 design.
The Development Plans will be progressed by the Developer during the period between the date of the Conditional Agreement and the Completion Date to include the following information and detail:
The Developer must submit the Development Plans to LUL in accordance with procedure set out in the Works Agreement.
This condition will be satisfied once LUL has confirmed in writing to the Developer that the Development Plans have reached RIBA Stage 3.
The parties acknowledge that, notwithstanding satisfaction of this condition, the Development Plans will continue to be updated and amended in accordance with the Works Agreement.
Following satisfaction of the Development Plans Condition, LUL must notify the Developer if it considers that consent is required from the Secretary of State.
As soon as reasonably practicable following satisfaction of the Development Plans Condition and in any event within 20 business days of the same LUL must notify the Developer if it considers (in its absolute discretion) that consent is required from the Secretary of State pursuant to section 163 of the Greater London Authority Act 1999 (a “S.163 Consent”) in respect of any disposal to be made by LUL and/or TTLP pursuant to the terms of the Conditional Agreement.
If LUL serves a notice confirming that a S.163 Consent:
The Developer must secure Development Funder(s) to provide equity or debt finance for the Development. The Funder must meet the indemnity requirements of LUL and agree the Funding Proposal.
The Conditional Agreement is conditional upon the Developer securing Development Funder(s) to provide equity and/or debt finance for the Development or Development Funder(s) as part of a “Funding Proposal” which has been approved by TTLP as set out below.
The “Development Funder” must be a bona fide, arm’s length funder and be:
who in each case has provided or will be providing funding for the Development or a material part of it whether directly to the Developer or to any Affiliate of the Developer (including a security trustee on behalf of such a funder).
The “Development Funder” must not be a “Prohibited Person” (as defined by the Conditional Agreement).
The Developer must, not less than two months prior to the Longstop Date, provide to TTLP for its approval:
(together known as the “Funding Proposal”).
“Covenant Strength Test” means:
“Bank Guarantee” means a bank guarantee in favour of LUL and TTLP in respect of the Developer’s liability under the Works Agreement which is:
“Hybrid Covenant Strength Test” means the Developer alone or when considered with any Developer Guarantor has/have “Net Assets” equal to or greater than four times the amount by which the Bank Guarantee is less than £70 million.
The Developer must procure that any Developer Guarantor referred to in an approved Funding Proposal will on the Completion Date enter into the relevant documents set out in the Conditional Agreement and covenant with TTLP and/or LUL in each of those relevant documents in the forms attached to or as provided for in the Conditional Agreement.
Step down and Reduction of Bank Guarantee
TTLP agrees that after the Completion Date the amount guaranteed by the Bank Guarantee which satisfies this Condition shall be permitted to reduce:
The Works Agreement contains the following limits on the liability of the Developer under the Works Agreement:
Review of the Cap
The £70M cap is subject to review after 5 years from entry into the Works Agreement.
The “Developer’s Acquisition Contract” becoming unconditional in accordance with its terms.
The conditional sale agreement dated 7 May 2021 between (1) 4C Hotels (2) Limited (2) 4C Minories 2 Ltd and (3) the Developer in respect of the 4C Freehold Property and the 4C Leasehold Property (as amended by a supplemental agreement between the same parties dated 25 April 2022 and as may be further varied from time to time with TTLP’s prior written approval (not to be unreasonably withheld or delayed).
Completion of the Conditional Agreement will occur 20 business days from the date on which the Development Notice is served.
The Development Notice is the notice to be given by the Developer to LUL specifying that:
(to the extent not already released).
entered into by TTLP and LUL.
on completion of the transaction, the current ownership titles will be merged, surrendered and two new headleases granted.
On completion of the transaction, the Freehold Property will be merged into one title under TfL’s ownership.
The Leasehold property will be surrendered, including the LCR lease.
The following steps will then occur:
LUL (at the discretion of TTLP) will grant Headlease 2 to the Developer (and its Guarantor).
500 year lease, subject to a gearing of 5.0% of rents receivable and a minimum ground rent of £375,000 per annum following Practical Completion.
LUL (at the discretion of TTLP) will grant Headlease 1 to Lunaprop.
500 year Long Leasehold interest, subject to a gearing of 2.5% of rents receivable and a minimum ground rent of £170,000 per annum following Practical Completion.
LUL (at the direction of TTLP), Lunaprop and the Developer if not already completed.
LUL (at the direction of TTLP), Lunaprop and the Developer must enter into the estate management deed (the principles of which are set out in the Conditional Agreement) (the “Estate Management Deed”). The Developer must procure that 4C Hotels (2) Limited and 4C Minories 2 Ltd (“4C Hotels Group”) enter into the Estate Management Deed.
The deed will detail the management structure and practical arrangements for the operational activities on the development, both during construction and into steady state. It complements the Open Space Specification and Method Statement, and the Delivery and Servicing Management Plan by describing how the Estate common parts will be effectively managed by one legal entity.
It focuses on how these areas, including the public realm, play facilities and basement common parts will be maintained to a high standard. This deed explains who will be responsible for these activities and summarise the robust legal structure which will guarantee adequate funding will always be in place to meet the costs of access and servicing, cleaning and landscaping, and security across the Minories Estate.
from Gateway 1 until the Gearing RCD which is the earlier of the third anniversary of the date of the lease or 6 months from and including PC.
within 6 months of the date the Development Notice is served.
is defined as: - the later of the relevant Practical Completion Date in respect of:
The minimum ground rent of £375,000 per annum (reviewed every 5 years) and; 5.00% of Property Rents (Rents Receivable).
is defined as the later of:
in connection with the Relevant Works.
Release of the Developer’s Liability
On the date of issue of the final certificate of making good defects in connection with the Relevant Works, the Developer shall be released from liability arising from breach or non-performance of the Developer’s obligations under the Works Agreement (save in respect of any claims notified prior to such date).
Relevant Works is defined as:
The Developer is to provide sufficient information to LUL to identify which works may have an effect on the Transport Assets and Premises and any other relevant information as LUL may require. The elements of the works that require engineering consents shall be identified by LUL (the “Relevant Works”). It is agreed that any works to the footpath/accessway and landscaping area between the site of the Development and the adjacent operational bus station will form part of the Relevant Works. It is acknowledged that there may be modifications to the Development which may impact on what is comprised in the Relevant Works and that, following submission of any further information LUL requires, LUL is entitled to revise its opinion on what constitutes the Relevant Works.
Headlease 2 (Developer) is subject to a 5.00% gearing of Rents Receivable. There is a rent payable from Gateway 1 throughout the construction period (subject to a longstop), which rises to the geared rent, subject to a minimum of £375,000 per annum following Practical Completion.
No Ground Rent Payable
No Ground Rent Payable
£50,000 per annum until the Gearing RCD which is the earlier of the third anniversary of the date of the lease or 6 months from and including PC.
£205,000 per annum until the RCD date which is the earlier of the third anniversary of the date of the lease or 6 months from and including PC.
The minimum ground rent of £170,000 per annum (reviewed every 5 years)
and
2.5% of Property Rents (Rents Receivable).
The minimum ground rent of £205,000 per annum (reviewed every 5 years)
and
2.5% of Property Rents (Rents Receivable).
At Rent Review (every 5 years) the Minimum Ground Rent (Developer Lease) is reviewed to the higher of:
1. the minimum ground rent payable immediately prior to the relevant review date;
2. 50% of the Average Ground Rent (A/5); or
3. 2.5% of the ERV at the relevant review date.
Where Practical Completion has not taken place by the 3rd anniversary of the date of the lease then for the period from the 3rd anniversary of the date of the lease to the PC date the ground rent payable will be 2.5% of the open market rental value of any unlet lettable areas for the financial year in question.
The Overage Deed is to be entered into upon completion of the Conditional Agreement between the Developer, TTLP and the Developer’s Guarantor or other guarantor provided pursuant to the terms of the Conditional Agreement.
There are potentially two types of overage received by TTLP pursuant to the terms of the Overage Deed.
In the event that at the date of issue of the certificate of practical completion the measured area of the Property as determined by the measuring surveyor exceeds 225,000 square feet the Developer is obliged to pay overage equivalent to £100 per square foot (exclusive of VAT) by which the measured area of the Property exceeds 225,000 square feet.
This is based upon 25% of the Profit received by the Developer after a priority return of 22.5%. The Profit is calculated as follows:
A = B – (C+D)
Where
A is the Profit
B is the Qualifying Disposition Consideration
C is the Actual Development Costs
D is the Priority Return (being 25% of Actual Development Costs)
Gross Proceeds is the aggregate of total monetary consideration (excluding VAT) received or receivable by the Developer in respect of a Qualifying Disposition and in respect of any Investment Underlease of Part (being the grant of an underlease of less than the whole or substantially the whole of the Property with the intention of conferring a capital value on the lessee) the total monetary consideration (excluding VAT) received or receivable by the Developer prior to the date that the calculation of overage takes place. A Market Value determination applies where the overage liability is not triggered by receipt of Gross Proceeds (on Change of Control of the Developer or where the trigger for overage is 80% of the lettable areas become income producing or where there has been no disposal of the Headlease by the date which is 3 years from PC) or where TTLP has reason to believe that the relevant Qualifying Disposition is not a bona fide arm’s length transaction.
Actual Development Costs are based upon Development Costs less Income. There is an extensive list of Development Costs set out in the Overage Deed which is designed to capture all costs reasonably and property incurred in connection with the Development.
Costs must be incurred on or after the date of exchange of the Conditional Agreement and there is an assumed interest charge in connection with the provision of finance for the development works of 5% per annum compounded quarterly of all other costs included in Development costs.
Income is all sums received by way of payment towards or reduction in Development Costs from the date of the Overage Deed (but not including proceeds from a Qualifying Disposition).
The Triggers for Development Overage are the earlier of:
There is also the provision for a Contingent consideration (which is uncertain or the payment of which is conditional or contingent) is subject to a separate regime in respect of Development Overage.
